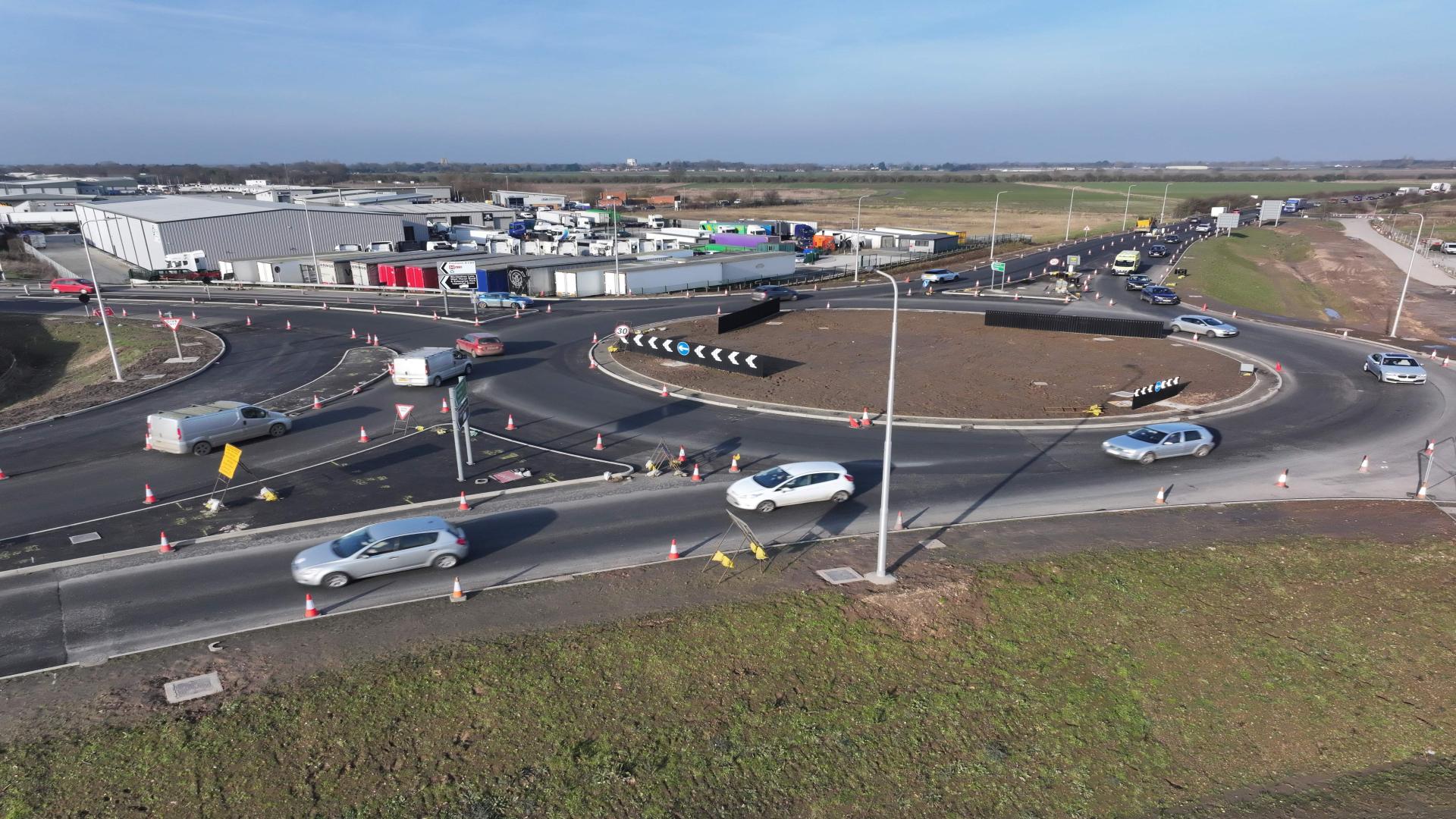

An overview of progress on the Pinchbeck Roundabout improvement project.
What we achieved in February
- Completed laying binder course and glass grid on A16 from Vernatt’s bridge to Springfield Roundabout
- Completed laying hot-rolled asphalt surface course on A16 from Vernatt’s bridge to Springfield Roundabout
- Completed laying base and binder courses in Pinchbeck Roundabout
- Cleared the old site compound
- Started installing vehicle restraint system at Pinchbeck Roundabout
- Site clearance / topsoil strip / earthworks along active travel zone footpath near Springfield shopping centre
What’s happening in March
- Laying hot-rolled asphalt surface course
- Road-making and CKD/gullies cleaning along A16
- Install asphalt plug/mechanical and buried joints along A16, from Pinchbeck Roundabout to Springfield Roundabout
- Install the remaining vehicle restraint system infrastructure / install fencing / lay road markings / begin landscaping at Pinchbeck Roundabout
Current/ongoing traffic restrictions and closures
- Ongoing narrowed lanes on A16 in the roundabout and all its approaches
- Ongoing night-time closure of the roundabout, all its legs and sections of the A16 until the end of March, weekday evenings only, 8pm to 6am (subject to weather)
- Footpath closure from the A151 (adjacent to Coronation Channel) as and when required
- Temporary closure of the northern footway on A151 Holbeach Road as needed
- The diversion route for pedestrians will be on the opposite side of carriageway
Upcoming traffic restrictions
- Off-peak hours lane closures and cycle lane suspension at Springfield Roundabout (dates to be confirmed)
For more information about this and other major highways projects, visit www.lincolnshire.gov.uk/pinchbeckroundabout.
