A16 Pinchbeck Roundabout September update

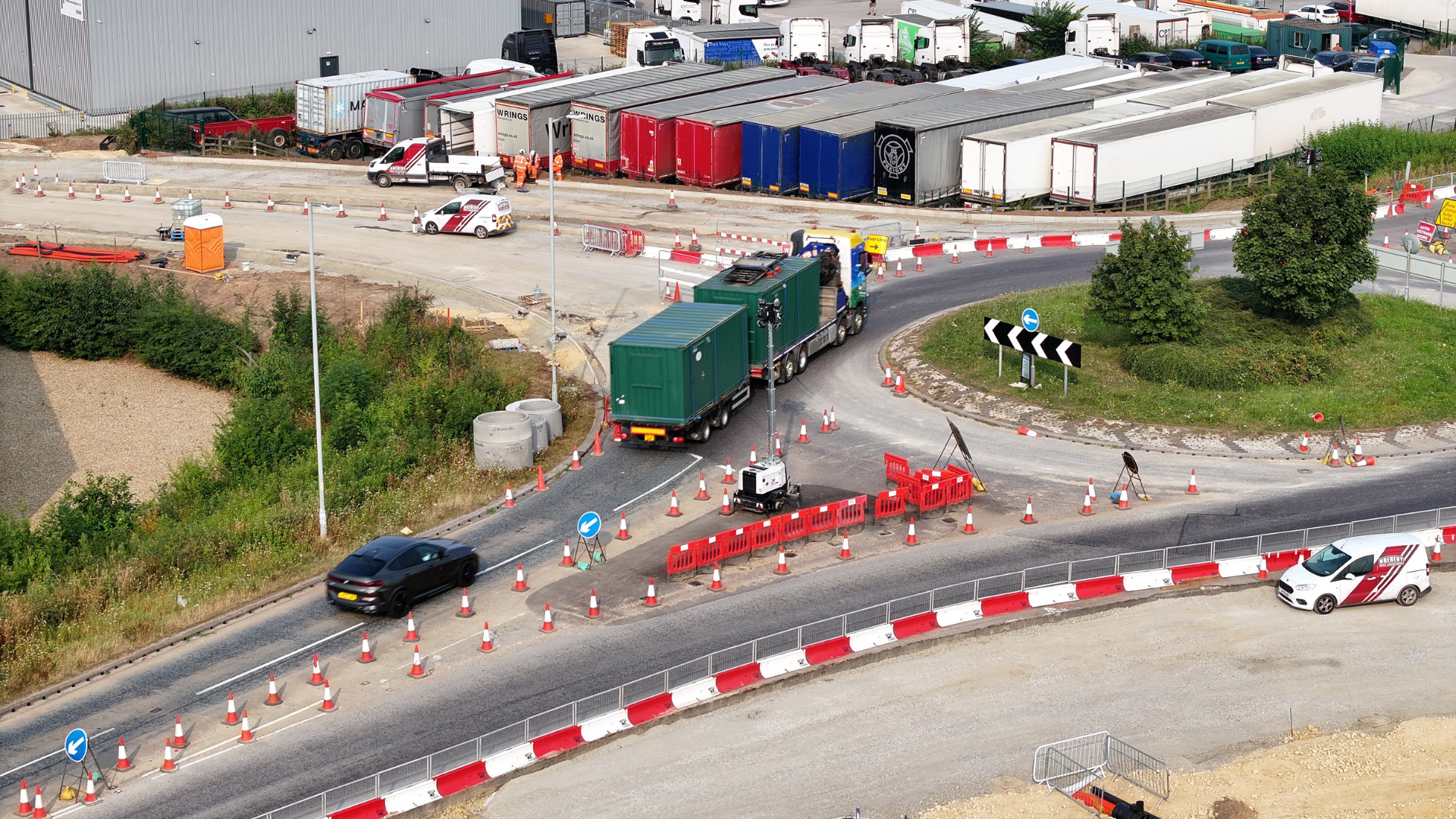

A view of the Pinchbeck roundabout

The latest update on Pinchbeck Roundabout.

What we achieved in August

  • Completed construction of widened sections of B1180, including surfacing and kerbing
  • Cleared the existing west-side ditch along B1180
  • Installed street lighting ducts/chambers on B1180
  • Topsoiled the verges
  • Completed the reinforced road base on the north side of A16
  • Laid kerbs on north and south sides of the A16

What’s happening in September

  • Lay road markings / install vehicle restraining system / additional works to B1180
  • Open B1180 to traffic
  • Surface the widened sections of A16 North and South
  • Install vehicle restraining system on the north and south sides of A16
  • Install narrowed lanes and begin work in the existing circular island

Current/ongoing traffic restrictions and closures

  • 24/7 closure of B1180 until mid-September
  • Ongoing narrowed lanes along the south and the north approaches of the roundabout

Upcoming traffic restrictions

  • Re-open the B1180 to traffic
  • Narrowed lanes on the northbound at the roundabout approach and departure / B1180 entry and departure / new circular island
